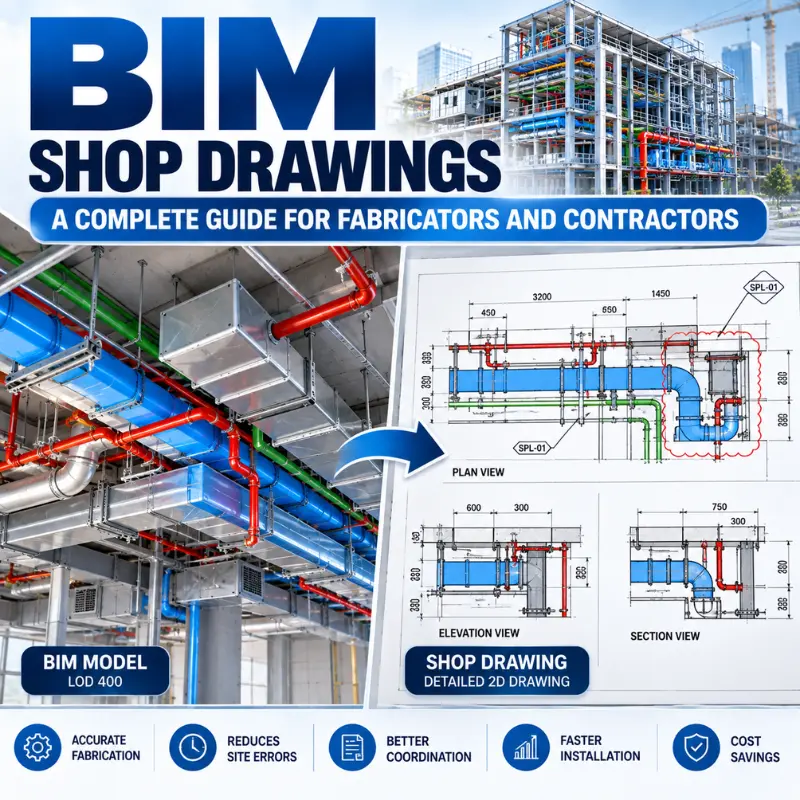

BIM Shop Drawings: A Complete Guide for Fabricators and Contractors
Eminent BIM TeamSep 29, 20269 min read1659 words
BIM shop drawings are extracted from coordinated LOD 400 models not generated by them. This guide covers the LOD prerequisite, discipline-specific requirements, the submittal process, and why drawings still get rejected even when the model is solid.
BIM shop drawings are fabrication-ready, 2D technical documents extracted from a coordinated Building Information Model typically at LOD 400 that communicate exact dimensions, materials, assembly sequences, and installation details to the trade responsible for building or installing a component.
They are not a replacement for the BIM model. They are the contractually submitted, engineer-reviewed deliverable that turns model geometry into something a fabricator can legally build from.
Key Takeaways
BIM shop drawings are generated from a coordinated 3D model; they do not replace it, nor does the model replace them.
LOD 350 (clash-free, with connections and interfaces modelled) is the minimum base from which LOD 400 fabrication-ready shop drawings can be extracted reliably.
Structural, MEP, and architectural millwork shop drawings have different content requirements, approval chains, and software tools they are not a single document type.
The most common rejection reason during submittal review is not inaccurate geometry it is incomplete cross-referencing of RFI responses, missing revision clouds, and absent weld or joint callouts.
BIM-generated shop drawings reduce coordination rework compared to CAD-drafted equivalents because clashes are resolved in the model before a single sheet is produced.
An outsourced BIM shop drawing package requires a well-structured BIM Execution Plan (BEP) and clearly agreed LOD specifications before production starts without these, revision cycles multiply fast.
What BIM Shop Drawings Actually Are
A BIM model and a BIM shop drawing are not the same thing. The model is a live, data-rich 3D environment. The shop drawing is a static, 2D document a specific slice of that model at a defined moment in the project submitted for review, approved with a stamp, and used as the legally binding fabrication instruction.
This distinction matters because a persistent misconception in the AEC industry suggests that a sufficiently detailed BIM model makes shop drawings redundant. It does not.
The engineer of record does not review the model during a submittal cycle. They review the 2D drawing set. The model informs the drawing; the drawing carries contractual weight.
What BIM changes is how those drawings are produced and how reliable they are before they reach the reviewer's desk.
The LOD Prerequisite Nobody Mentions
Here is the part most guides skip over: you cannot reliably extract fabrication-quality shop drawings from a BIM model unless the model has already reached a specific level of coordination.
The American Institute of Architects LOD framework defines a progression from LOD 100 (conceptual massing) through to LOD 500 (as-built). For shop drawing production, the relevant thresholds are:
LOD 300: Accurate geometry and confirmed dimensions. Suitable for design documentation and quantity take-offs. Not yet sufficient for shop drawings.
LOD 350: Connections, interfaces, supports, and penetrations are modelled. Clash detection has been run and resolved. This is the minimum pre-condition for beginning LOD 400 work.
LOD 400: Full fabrication geometry, manufacturer-specific data, exact tolerances, and assembly instructions. This is the level from which shop drawings are extracted.
Subcontractors who attempt to generate shop drawings from an under-coordinated LOD 300 model common on compressed programmes almost always produce drawings that fail submittal review or create costly on-site conflicts.
The re-coordination cycle that follows costs more in time and fee than proper coordination upfront would have.A fully coordinated LOD 350 federated model is not overhead. It is the prerequisite.
The Workflow: From Model to Approved Drawing
The BIM shop drawing process follows a defined sequence. Each step has a clear owner and a clear output.
Design intent review: The fabricator or BIM coordinator reviews the architect's and engineer's design drawings and the federated model to understand scope, system intent, and project-specific sheet standards. At this stage, outstanding RFIs are logged every unresolved design question is a potential rejection reason later.
Coordination and clash detection: The relevant discipline model (structural, MEP, or architectural) is federated with other trades in Navisworks or an equivalent platform. Hard clashes two objects occupying the same space are resolved. Soft clashes insufficient clearance for maintenance or installation are documented and escalated.
LOD 400 model development: With a clean LOD 350 base, elements are detailed to fabrication standard: exact bolt circle diameters, flange face dimensions, support hanger locations, pipe spool boundaries. This is where the model earns its value.
Drawing extraction: Views, sections, and schedules are generated from the model. In Revit, this is largely automated plan views, sections, and schedules update when the model changes. Manual annotation is still required for weld callouts, surface finish specifications, revision clouds, and code references.
Internal QA: Before any external submittal, a qualified reviewer checks the drawing against the current model, confirms all RFI responses are reflected, and verifies that sheet numbering follows the project's document control protocol.
Submittal and review: Drawings are submitted to the architect, structural engineer, or MEP consultant for review not approval of design intent, but confirmation of conformance with design intent. The reviewer stamps the drawing: typically "Approved," "Approved as Noted," "Revise and Resubmit," or "Rejected."
Revision and re-submittal: Comments are addressed in the model first, then reflected in the drawing. This model-first revision discipline is where BIM workflows pay dividends a change in one view propagates across all views automatically.
The honest caveat: BIM shop drawings are only better if the model is properly coordinated. A poorly built LOD 300 model fed into a shop drawing workflow produces drawing errors that are harder to trace and fix than equivalent CAD errors, because assumptions baked into the model are invisible on the 2D sheet.
Discipline-Specific Differences
Shop drawings are not a single document type. What a structural steel shop drawing contains is fundamentally different from an MEP fabrication drawing or an architectural millwork package.
Structural steel. Connection details, bolt patterns, weld symbols, camber specifications, and erection marks are the core content. Software: Tekla Structures is the industry standard for steel detailing, with outputs including CNC-ready DSTV files that feed fabrication machinery directly from the model. Approval chain: structural engineer of record.
MEP mechanical, electrical, plumbing. Spool drawings for pipework show face-to-face dimensions, end preparation types, material callouts, and unique spool reference numbers. HVAC ductwork drawings show fitting geometry, seam directions, and hangar spacing. At LOD 400, MEP shop drawings can drive prefabricated duct and pipe assemblies built off-site and craned into position a workflow that is increasingly standard on data centre and healthcare projects in the UK and US. Approval chain: MEP consultant or mechanical engineer.
Architectural millwork and curtain wall. Shop drawings in this discipline cover custom casework dimensions, material species, grain direction, hardware schedules, and glazing bead details. Tolerances are tighter than structural work and must account for manufactured product variability. Approval chain: architect of record.
The distinction matters for outsourcing decisions. A BIM consultancy that handles MEP spool drawings competently may not have the Tekla-trained structural detailers required for a steel fabrication package. Scope clarity prevents scope creep and mis-delivered work.
Why Shop Drawings Get Rejected
Rejection during submittal review is expensive, Each revision cycle adds days to the programme and fee pressure to the subcontractor. The most common rejection reasons are not what most guides suggest.
Inaccurate geometry accounts for fewer rejections than expected on BIM-generated packages. The more frequent causes are:
Unresolved RFIs reflected as assumptions: The drawing proceeds based on the drafter's interpretation of an open design question. The reviewer sees an assumption they did not approve.
Missing revision clouds: When a drawing is revised and re-submitted, every change must be clouded and tagged with a revision number. Omitting this makes the reviewer re-check the entire sheet rather than focusing on changes and many reviewers reject on this basis alone.
Absent or incorrect weld and connection callouts: Particularly on structural steel packages, missing AWS weld symbols or incorrect pre-qualification references trigger automatic rejection from most structural engineers.
Failure to reference the current specification issue: Specifications are revised during design. If the shop drawing references a superseded specification section, the reviewer cannot confirm compliance without flagging it.
Sheet scale inconsistencies: A detail drawn at 1:20 but labelled 1:10 creates legal ambiguity about what was approved. On BIM-extracted drawings, this error occurs when views are copy-pasted without updating the annotation.
Prefabrication Is Raising the Bar
Off-site construction is changing what BIM shop drawings need to contain. On a traditional site-installed MEP project, a shop drawing communicates installation intent. On a prefabricated MEP project, the same drawing is a manufacturing instruction- it feeds the fabrication shop directly, and errors discovered after a module is built cost orders of magnitude more than errors caught in the model.
This means LOD 400 for prefabricated assemblies must include spool and module boundary definitions, maximum transport dimensions, assembly sequence notes, and QC test point callouts- detail that exceeds what most standard shop drawing templates include. The Bimeco and BIMacme guidance on LOD 400 prefab packages reflect this raised standard.
For BIM consultancies like Eminent BIM Services delivering MEP shop drawing packages to fabricators in the US, UK, and UAE, this shift has practical implications: the BEP must specify prefabrication intent from day one, and the model must be structured accordingly. A model built for coordination will not automatically serve prefabrication without additional detailing effort.
Standards and Compliance
On ISO 19650-compliant projects the information management standard widely adopted across the UK, UAE, Australia, and increasingly in parts of the US shop drawings are a defined information deliverable with a required naming convention, revision protocol, and CDE (Common Data Environment) upload path.
The BIM Execution Plan on an ISO 19650 project will specify which information containers (drawings) are required at which project stage, who authors them, who reviews them, and what the acceptance criteria are. Shop drawings submitted outside this protocol wrong naming format, wrong revision state, uploaded to the wrong CDE container are typically returned without review.
Teams working across multiple markets should be aware that the AIA's LOD framework (dominant in the US) and the UK BIM Framework's LOIN (Level of Information Need) approach use different terminology for similar concepts. LOD 400 in AIA terms broadly aligns with the LOI required for fabrication under UK BIM Framework guidance, but the frameworks are not identical and should not be conflated in a project BEP.
Check the model for geometry, dimensions, levels, materials, connections, and coordination requirements before preparing shop drawings.
3
Develop Detailed Components
Model fabrication-level details such as dimensions, connections, openings, supports, joints, penetrations, and installation requirements.
4
Coordinate With Other Disciplines
Perform BIM coordination and clash detection to identify conflicts between architectural, structural, and MEP elements.
5
Generate Shop Drawing Views
Create plans, elevations, sections, details, enlarged views, schedules, and installation diagrams required for fabrication and construction.
6
Conduct Quality Control (QC)
Check drawings against the BIM model, approved design documents, project standards, and client requirements.
7
Issue for Fabrication or Construction
After approval, issue the final drawings using the project's document-control procedure and revision system.
Frequently Asked Questions
No and this is the most consequential misconception in the industry. The BIM model is the coordination and design tool. The shop drawing is the legal submittal document reviewed and stamped by the engineer of record. No current contractual framework replaces the stamped 2D drawing with model access as the basis for contractor responsibility. The model improves the drawing; it does not replace it.
For architectural and MEP shop drawings, Autodesk Revit is the most common authoring tool, with sheets extracted directly from the model. For structural steel, Tekla Structures is the industry standard and outputs both shop drawings and CNC fabrication files. Navisworks is used for coordination review before drawing extraction, not for sheet production.
LOD 400 is the minimum for fabrication-ready shop drawings. Achieving LOD 400 requires a clash-free LOD 350 federated model as a prerequisite. Attempting to extract shop drawings from an LOD 300 model produces higher rejection rates and additional revision cycles.
The design team architect of record, structural engineer, or MEP consultant, depending on discipline reviews shop drawings for conformance with design intent. They do not redesign during review. The contractor remains responsible for fabrication means and methods. Approval does not transfer design liability from the engineer to the contractor.
Pricing varies significantly by discipline, model quality, drawing volume, and market. Outsourced MEP shop drawing packages from specialist BIM consultancies typically range from $1,500 to $8,000 per floor or system, depending on complexity (est.). Structural steel detailing is often priced per tonne of steel. Clarity on LOD requirements and drawing sheet count before engagement is the single most effective way to control cost.
Partially. Views, sections, and schedules can be generated automatically, and Revit's sheet composition tools significantly reduce manual drafting time. However, weld symbols, revision clouds, code cross-references, specification callouts, and QA annotations require manual input. Full automation is not yet practical for submittal-quality drawing packages.
A shop drawing is produced before fabrication and installation it describes what will be built, and it is subject to review and revision. An as-built drawing is produced after installation and documents what was actually constructed, including field deviations. On BIM projects, as-builts are typically produced by updating the LOD 400 model to reflect field conditions, then re-extracting sheets resulting in an LOD 500 model.
The BIM consultant or outsourced team must work within the project's CDE, follow the agreed naming convention and revision protocol, and upload deliverables to the correct Work In Progress → Shared → Published workflow. This requires the BEP to explicitly name the outsourced party as an information author and define their information responsibilities. Without this, CDE access, responsibility matrices, and review chains are undefined.
