What Is Level of Development (LOD) in BIM? A Complete Guide

Eminent BIM Team Oct 09, 2026 8 min read 1552 words
Level of Development (LOD) in BIM explained from LOD 100 to LOD 500 with progressive 3D building models, structural details, MEP systems, and construction visualization.

Level of Development (LOD) in BIM defines how reliably a model element has been developed not how detailed it looks. This guide covers every LOD level from 100 to 500, the LOD 300 vs LOD 350 distinction, and how LOD requirements should be written into a BIM execution plan.

Level of Development (LOD) in BIM is a standardized framework that defines how completely and reliably a model element has been developed at a specific stage of a project. It tells every member of the project team - architect, engineer, contractor, or owner - exactly what they can use that element for, and what they cannot. It does not measure how detailed something looks. It measures how much you can trust it.

Key Takeaways
  • LOD stands for Level of Development, not Level of Detail. These two terms are not interchangeable, and confusing them causes real coordination problems on site.
  • The LOD framework runs from LOD 100 (conceptual) through LOD 400 (fabrication-ready), plus LOD 500, which is a field-verified record - not a higher level of geometry.
  • LOD 350 was added specifically to close the coordination gap between design intent and fabrication. Most projects that skip it pay for the oversight later.
  • LOD applies at the element level, not the model level. A structural column can be at LOD 300 while an HVAC duct in the same model sits at LOD 200.
  • The governing reference standard is the BIMForum Level of Development Specification 2026, which expands on the AIA G202 framework. Every project BEP should cite the version used.

What Is Level of Development in BIM?

Level of Development is a shared language. That's the simplest way to put it.
Without it, "complete model" means whatever the person typing the contract wants it to mean. The architect thinks complete means coordinated geometry. The structural engineer thinks it means construction-document quality. The mechanical contractor thinks it means ready to fabricate. All three are right about different things - and without a LOD specification in the BIM Execution Plan, that ambiguity becomes a very expensive dispute at the construction administration phase.

The BIMForum LOD Specification, first published in 2013 and updated annually - the current version being the 2026 edition available at bimforum LOD - gives the industry a structured answer. It defines the LOD framework element by element, discipline by discipline, so that a LOD 300 structural beam means exactly the same thing on a hospital project in Houston as it does on a mixed-use development in London.

Level of Detail vs. Level of Development: Get This Right First

This is the one mistake that derails more BIM coordination reviews than any other. So let's be direct about it.
Level of Detail describes how graphically rich an element looks. A door family with a highly rendered panel, hardware, and frame looks detailed. Level of Development describes whether the information attached to that door is reliable enough to use for a specific purpose cost estimation, coordination, fabrication, or handover.
You can have an element that looks extremely detailed (high Level of Detail) but carries no verified dimensions, no manufacturer reference, and no confirmed position relative to its neighbors. That element has high Level of Detail and low Level of Development. It looks useful. It isn't.

The BIMForum specification uses Level of Development exclusively. When a contract or BEP refers to "LOD," it means Level of Development. Full stop.

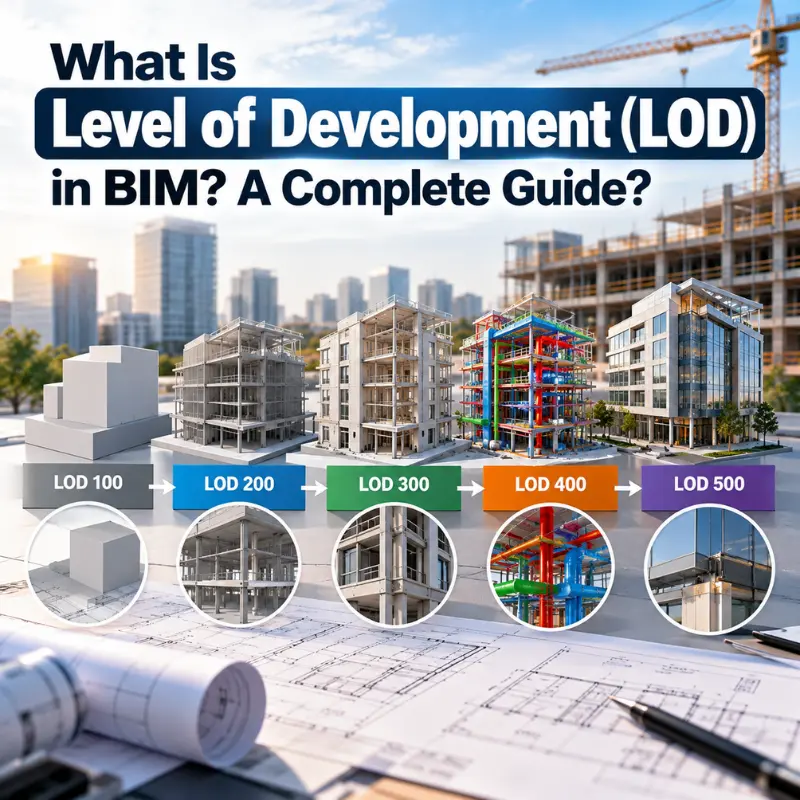

The Six LOD Levels Explained

LOD 100 - Conceptual Representation

At LOD 100, a model element exists as a massing object or generic symbol. It communicates that something is there and roughly where, but not what it is precisely. Dimensions are approximate. The element may not even carry a specific geometry - a wall system might appear as a surface mass.

What it supports:

Feasibility studies, conceptual cost allowances (typically expressed as $/m² of floor area or $/hospital bed), high-level phasing, and early stakeholder presentations.

What it does not support:

Any kind of specific quantity take-off, trade coordination, or design confirmation.

LOD 200: Schematic Design / Approximate Geometry

LOD 200 elements carry approximate size, shape, location, orientation, and quantity. The operative word is approximate - dimensions are representative, not confirmed. A structural beam modelled at LOD 200 shows the correct depth range but not the final section size.

What it supports: Schematic design coordination, discipline-to-discipline clash identification at a major-system level, and estimated cost based on measurement of generic element types. A generic interior wall at LOD 200 supports a cost estimate- a specific wall type with confirmed assembly does not yet exist at this stage.

LOD 300: Precise Geometry, Specific Assembly

This is where most commercial BIM deliverables live. LOD 300 elements carry accurate geometry, confirmed dimensions, precise location relative to the project origin, and enough non-graphic data to produce coordinated construction documents.
What it supports: Design coordination, specific quantity take-offs, design development and construction document production, and cost estimation tied to a confirmed assembly type (not just a generic element).
What it does not support: Inter-system interface coordination. That's what LOD 350 is for.

LOD 350: Coordination and Interfaces

LOD 350 was added to the BIMForum framework precisely because LOD 300 had a blind spot. A model fully developed to LOD 300 shows every system in its correct position. It does not show how those systems physically interact - the hangers, supports, brackets, sleeves, and connectors that one trade needs to account for when another trade runs through the same space.

LOD 350 closes that gap. Elements at this level include the interface geometry needed for coordination with other systems and trades. A structural beam at LOD 350 includes connections and embedments. A ductwork run at LOD 350 includes hangers and penetration details at walls and slabs.

This is the level where multi-trade clash detection becomes genuinely useful rather than aspirational. It is also the level a mechanical fabricator needs before committing to purchase orders for equipment. Teams that jump from LOD 300 straight to LOD 400 often discover, mid-fabrication, that a coordination issue was never resolved - because LOD 350 was never actually achieved.

LOD 400: Fabrication and Assembly

At LOD 400, a model element is complete enough to fabricate from directly. Geometry is exact. Assembly information, detailing, and installation dimensions are all present. This level is used by specialist subcontractors- steel fabricators, precast suppliers, MEP ductwork fabricators- who will manufacture components based on model output.
Cost implication: The cost figure that emerges at LOD 400 is not an estimate. It reflects the committed purchase price of a specific assembly at buyout. LOD 400 cost data is real procurement data.
Important note: Requiring LOD 400 across an entire model during the design phase is a waste of time and budget. This level is appropriate for specific elements and systems in the construction phase, not as a blanket deliverable.

LOD 500: Field Verified (As-Built Record)

Here is the most common misconception in BIM: LOD 500 is not geometrically more detailed than LOD 400. The BIMForum LOD Specification covers only LOD 100 through LOD 400 for element geometry and information requirements. LOD 500 is defined by the AIA as a field-verified as-built record.

What that means in practice: an element at LOD 500 has been physically verified on site and updated to reflect actual installed conditions. It is an owner's record, not a design deliverable. Its value is in operations and facilities management - not in construction coordination.

Clients who request "LOD 500 delivery" at project handover are asking for field-verified as-built accuracy. That is a legitimate ask. Clients who request "LOD 500 during construction" are either misinformed about what the level means or are describing something they should call LOD 400.

How LOD Maps to Project Phases

BIM elements do not all progress at the same pace. A structural frame may reach LOD 300 before MEP systems reach LOD 200. That is by design - the LOD framework operates at the element level, and a well-structured BIM Execution Plan specifies the required LOD for each element category at each project milestone.

LOD and the BIM Execution Plan

The BEP is where LOD requirements become contractually meaningful. A project that discusses LOD without a BEP is having a theoretical conversation. A project that specifies LOD in the BEP is setting enforceable deliverable standards.

A properly structured BEP LOD matrix names the responsible party for each element category, the required LOD at each project milestone, the software and format standards for delivery, and the AIA or BIMForum version being used as the governing reference. That last point matters more than most teams realise. Citing "LOD 300" without referencing a version of the BIMForum specification leaves room for interpretation that gets exploited when deliverable disputes arise.

At Eminent BIM Services, every project BEP we produce references the current BIMForum LOD Specification version, assigns LOD by discipline and element category, and ties each LOD milestone to a defined project deliverable. That structure protects both the client and the delivery team.

Why LOD 350 Is the Level That Decides Whether Coordination Actually Works

The industry undervalues LOD 350. Most conversations about LOD jump from 300 to 400 as though they are adjacent steps. They are not.

LOD 300 gives you a coordinated model in the sense that each discipline's systems are correctly positioned within their own domain. What it does not guarantee is that the structural engineer has accounted for the MEP contractor's hanger requirements, or that the civil engineer has coordinated with the plumbing team on penetration locations through retaining walls.

LOD 350 forces those conversations to happen in the model, not on site. The cost of resolving a coordination clash at LOD 350 in a model review meeting is measured in hours. The cost of resolving the same clash on site - when steel is fabricated, ductwork is ordered, and concrete is already cured - is measured in tens of thousands of dollars.

This is the practical reason LOD 350 exists. Projects that treat it as optional often discover why it was added.

Frequently Asked Questions

LOD stands for Level of Development. It defines how reliably a BIM model element has been developed at a specific stage of a project covering both geometric accuracy and the completeness of the non-graphic information attached to it. It should not be confused with Level of Detail, which refers only to graphical richness.
The primary standard in the AEC industry is the BIMForum Level of Development Specification, which expands on the AIA G202 framework. The 2025 edition is the current version, available at bimforum.org/lod. The BIMForum specification organises LOD requirements by CSI Uniformat element categories and is updated annually.
No - and this is one of the most persistent misconceptions in BIM practice. LOD 500 is not a higher level of geometric detail than LOD 400. The BIMForum LOD Specification formally addresses only LOD 100 through LOD 400. LOD 500 is defined by the AIA as a field-verified as-built record-its value is information accuracy against installed conditions, not geometric complexity.
LOD applies at the element level, not the model level. Different elements within the same project model can and typically do- sit at different LOD levels simultaneously. A structural frame may be at LOD 350 while an interior partition system in the same file is still at LOD 200. The BEP specifies the required LOD for each element category at each project milestone.
LOD 300 elements carry precise, confirmed geometry and design attributes. LOD 350 adds the interface geometry needed for coordination with adjacent systems - hangers, supports, brackets, penetration details, and embedments. LOD 350 is the level at which multi-trade coordination becomes fully executable and at which subcontractors can commit to fabrication sequences.
LOD 400 is appropriate for elements or systems that will be fabricated from the model directly- structural steel connections, prefabricated MEP assemblies, precast concrete components. It is not appropriate as a blanket deliverable for the entire model during design development. Requiring LOD 400 for all elements during the design phase significantly increases modelling cost without proportional coordination benefit.
LOD level directly determines the reliability of quantity take-offs and cost data. LOD 100 supports only conceptual allowances (e.g. $/m² of floor area). LOD 200 enables approximate quantity measurement of generic element types. LOD 300 allows specific assembly measurement for confirmed designs. LOD 400 ties directly to committed purchase prices from fabrication procurement. Estimators who work from a LOD 200 model as though it were LOD 300 produce cost figures with false precision.
